.
.
The Framework: what each dimension covers
Rating scale and decision rules
What the ratings mean and how the overall status is set

A project is rated on all five dimensions before an overall status is assigned.
01. Majority sets the status
More than 50% of the dimensions at the same risk level determines the overall risk level.
02. Ties escalate upward
If a project sits between two risk levels, the higher (more severe) level determines the final risk.
03. Tasks are always high risk
All task values must be classified as high risk — they represent unidentified or undefined gap-to-plan.
Reference
The full risk rating matrix

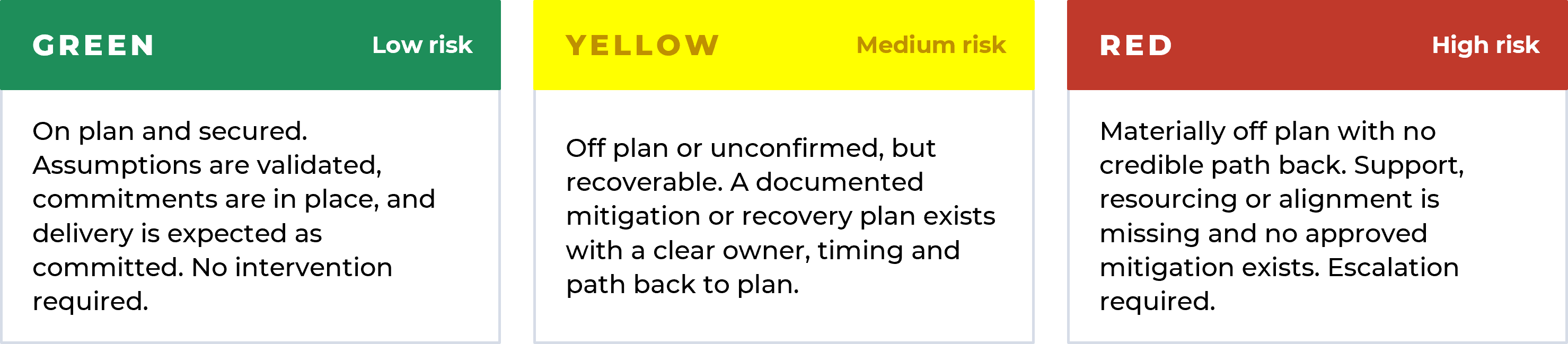

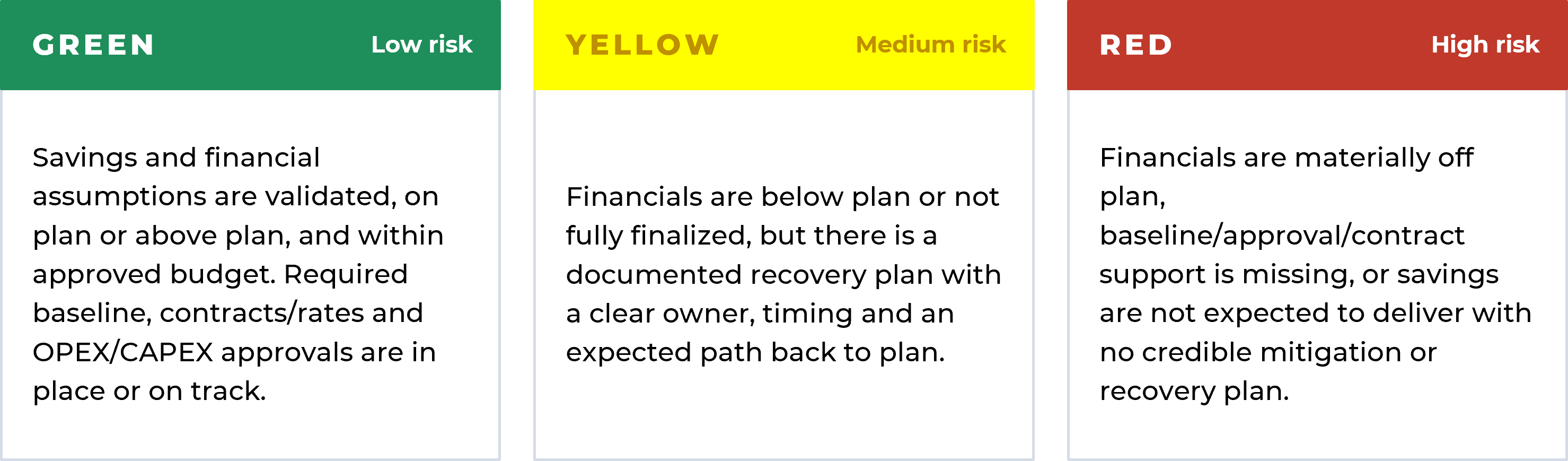

Dimension 1 of 5: Financials
Signed contracts · Fixed CY rates · Identified baseline · CAPEX approvals

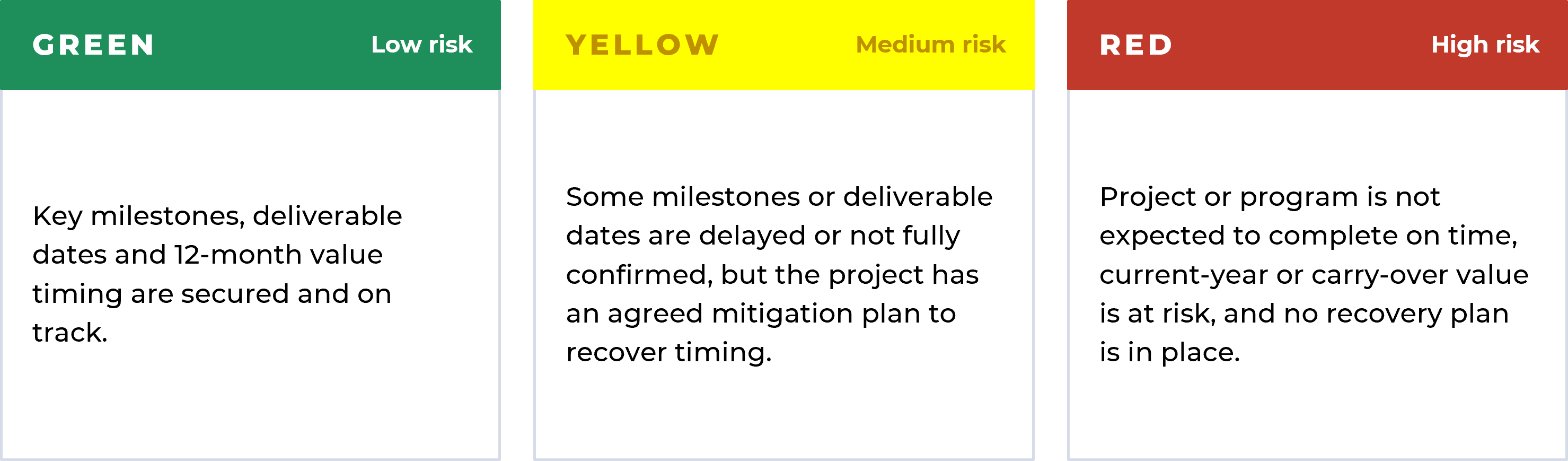

Dimension 2 of 5: Schedule
Secured timing · 12-month value (current year and carry-over)

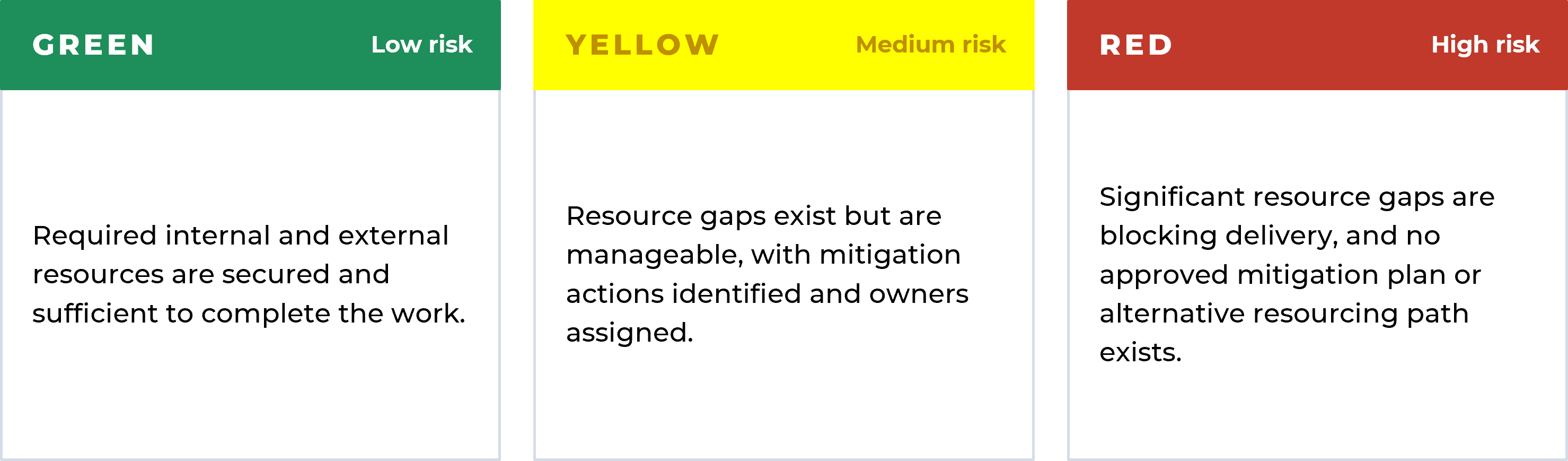

Dimension 3 of 5: Resources
R&D · Technology · Operations incl. plant and equipment · External and supplier

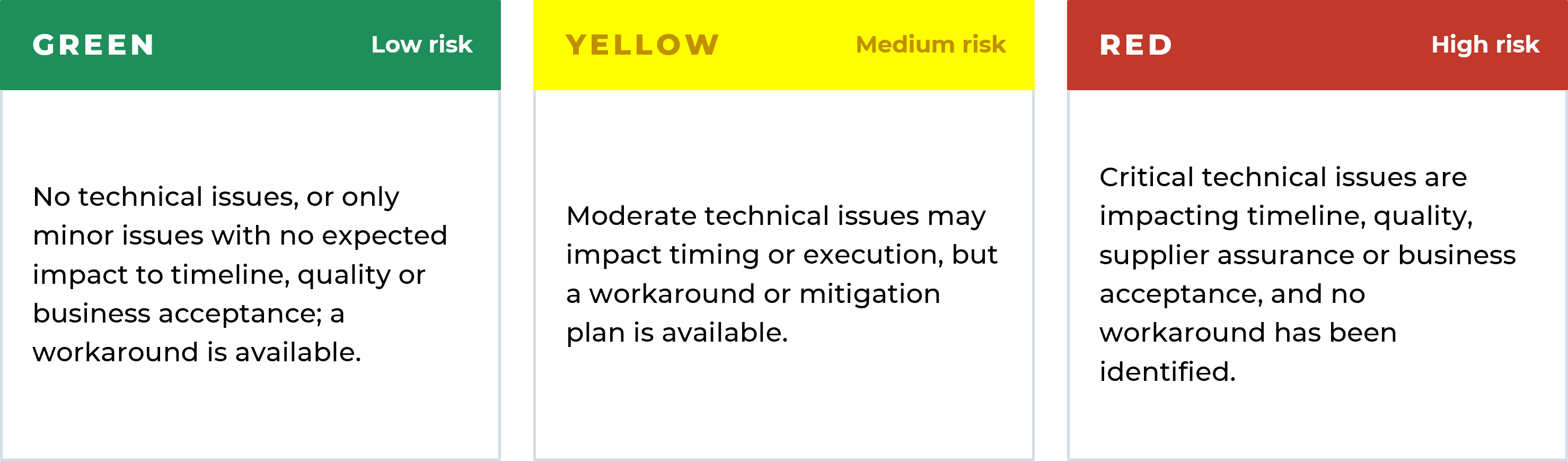

Dimension 4 of 5: Technical
Supplier quality assurance · Business acceptance

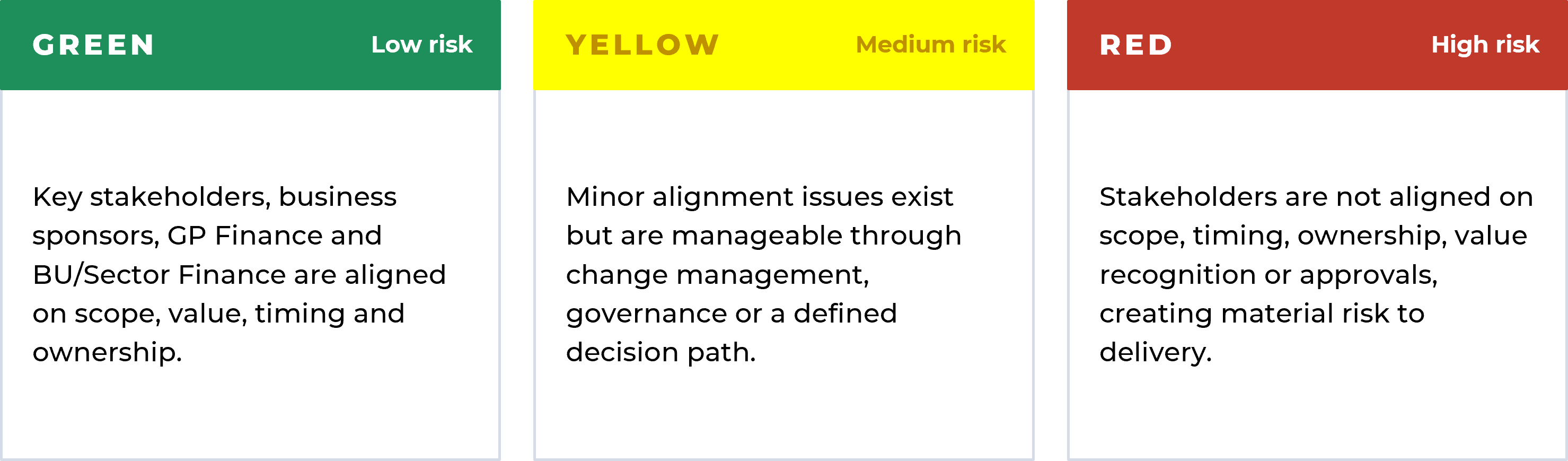

Dimension 5 of 5: Alignment
Key stakeholder alignment · Validated by GP Finance and BU/Sector Finance
Definitions: Taks and pipeline
Pipeline, in detail
Out of Plan | Pipeline Tracking
Pipeline in PowerSteering
Why we do it
Pipeline in PowerSteering is NOT a target commitment.
Portfolio Maintanance: Inactive projects
Projects that are not being actively delivered still need a consistent treatment so the plan reflects reality.
Applying the framework: Five checks before every status review
01. Rate every dimension
Score financials, schedule, resources, technical and alignment separately.
02. Apply the decision rules
Majority sets the level; a tie escalates to the higher risk level.
03. Evidence yellow and red
Every non-green rating needs an owner, a recovery plan and a date.
04. Classify tasks as high risk
Undefined gap-to-plan value is always reported as red.
05. Clean the inactive list
Move proposed and on-hold work out of plan; zero out cancelled value.inactive l
Cheat sheet: The framework on one page
Financials + Schedule + Resources + Technical + Alignment = OVERALL PROJECT STATUS
